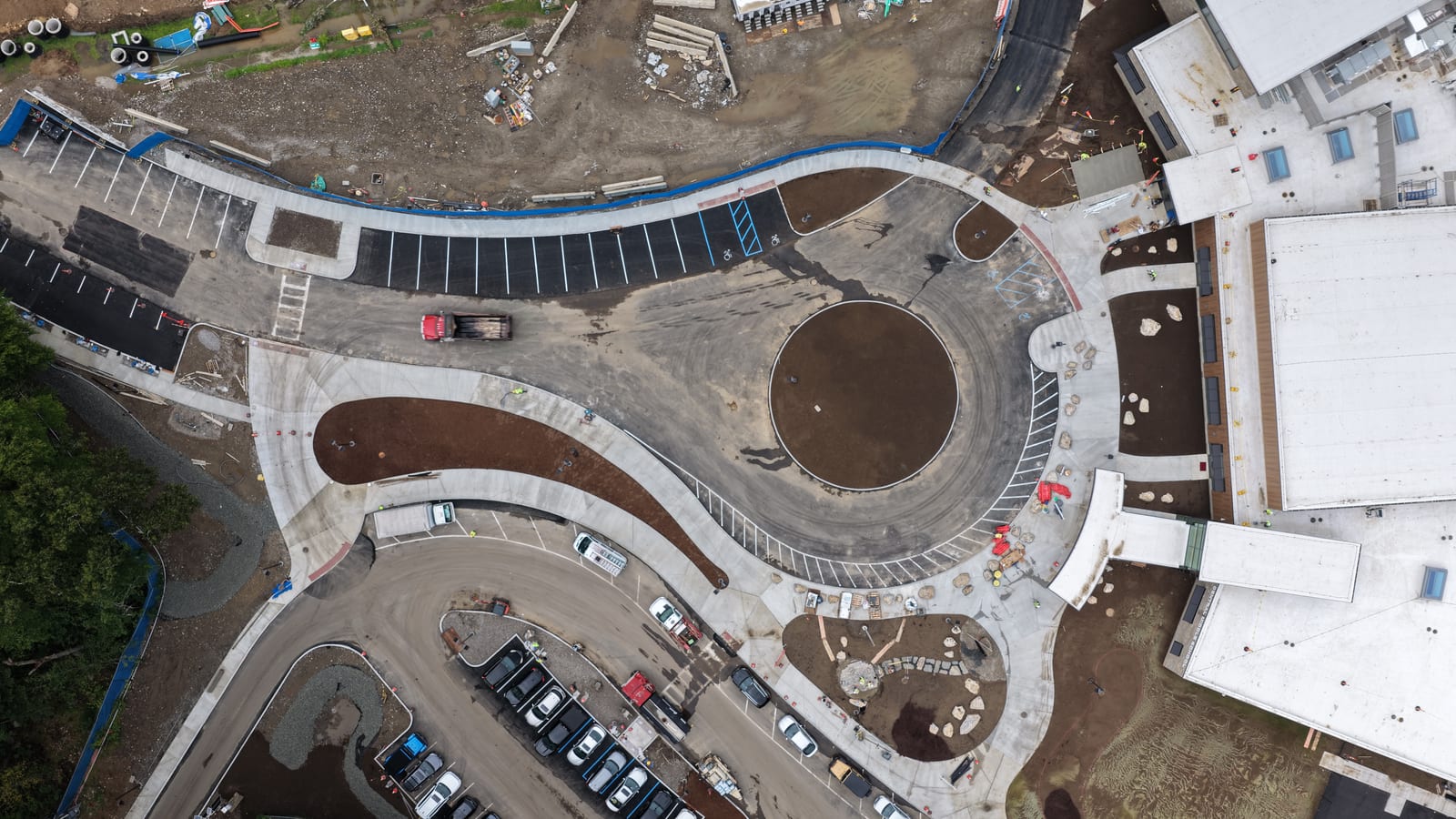

The aerial above is the before view: Central Middle School in Greenwich, Connecticut on Friday morning, August 21, 2026, with the designated lawn zones still open soil. By late afternoon, CT Sod's 11,000-square-foot sod scope was installed and watered ahead of Monday's ribbon cutting.
Turner Construction, general contractor for the new Greenwich Central Middle School project, contacted CT Sod on Tuesday with a deadline-critical request: 11,000 square feet of sod needed to be installed before the school's Monday ribbon cutting. Turner Construction called CT Sod directly for the rush commercial sod installation. CT Sod rearranged its installation schedule, mobilized to the active construction site on Friday, and completed the entire assigned scope that same day — first call to finished lawn in three days.
This is the full project record in the order it happened: the Tuesday call, the active construction site, Friday-morning conditions, installation progress, and the finished-school reveal.
Project Timeline
- Tuesday, August 18, 2026 — Turner Construction, the project's general contractor, contacted CT Sod about the rush installation and brought us in.
- Friday, August 21, 2026 — CT Sod mobilized to the Greenwich construction site and completed the full 11,000 square feet of sod installation.
- Monday, August 24, 2026 — Greenwich Central Middle School ribbon-cutting deadline, with the sod already down and watered in.
Tuesday: The Call and a Deadline That Would Not Move
Turner Construction, the general contractor for the Central Middle School project, contacted CT Sod on Tuesday, August 18 and brought us in. A high-visibility section of the new Greenwich school grounds still needed turf before Monday's ceremony with town officials, the superintendent, and students. The response window was measured in days, not weeks.
CT Sod scheduled fresh material, coordinated truck and crew timing around an active construction site, and mobilized for Friday. For a commercial job at this scale, speed only works when the harvest date, delivery sequence, pallet staging, installer count, site access, and watering handoff are planned as one operation.
A fixed public deadline changes the job. The material has to be cut fresh, the crew has to be sized for the footage, and the site has to be ready when the truck arrives. There is no extra day to recover from a missed handoff.

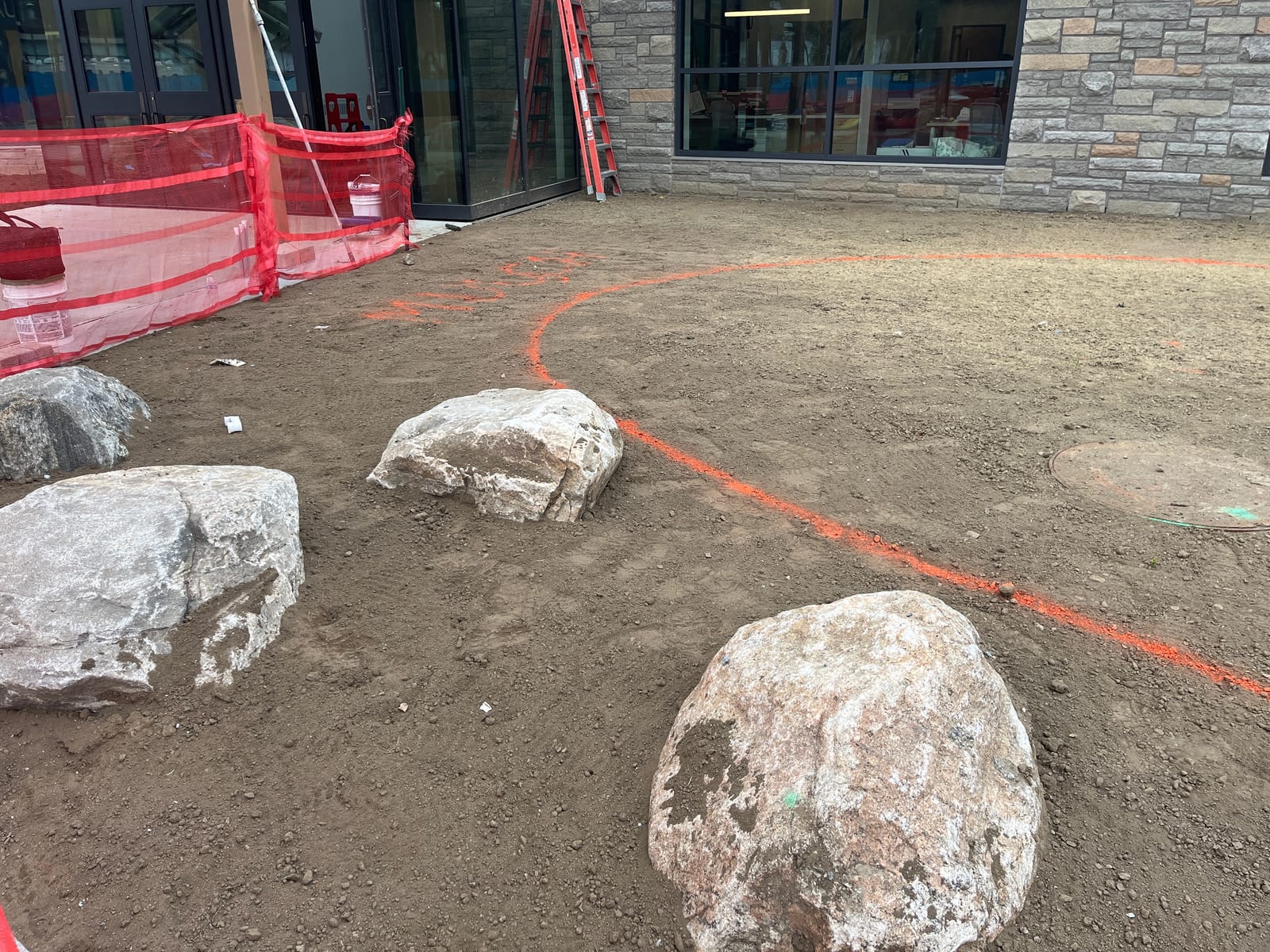

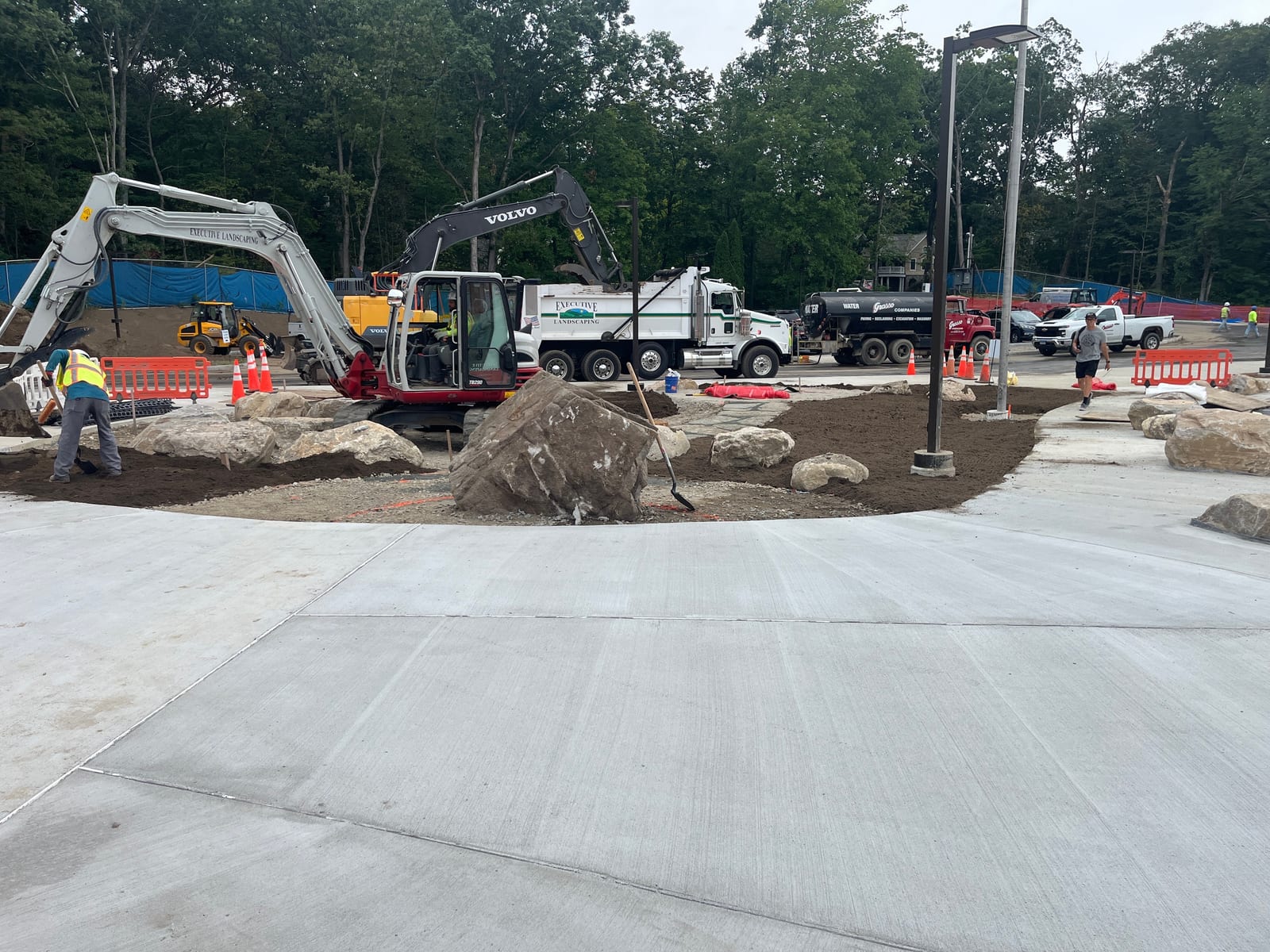

Before Our Crew Mobilized: An Active Construction Site
These photographs document the campus before CT Sod's Friday installation. They show the evolving grade, new walks, building frontage, and future lawn areas inside a much larger construction project. They are site context—not a claim that CT Sod performed every preparation task visible in the photographs.

These conditions explain why commercial turf schedules need a firm handoff. Sod is perishable after harvest. The farm cut, trucks, forklifts, and install crew must arrive when the designated areas are truly ready—not while the final grade is still changing.

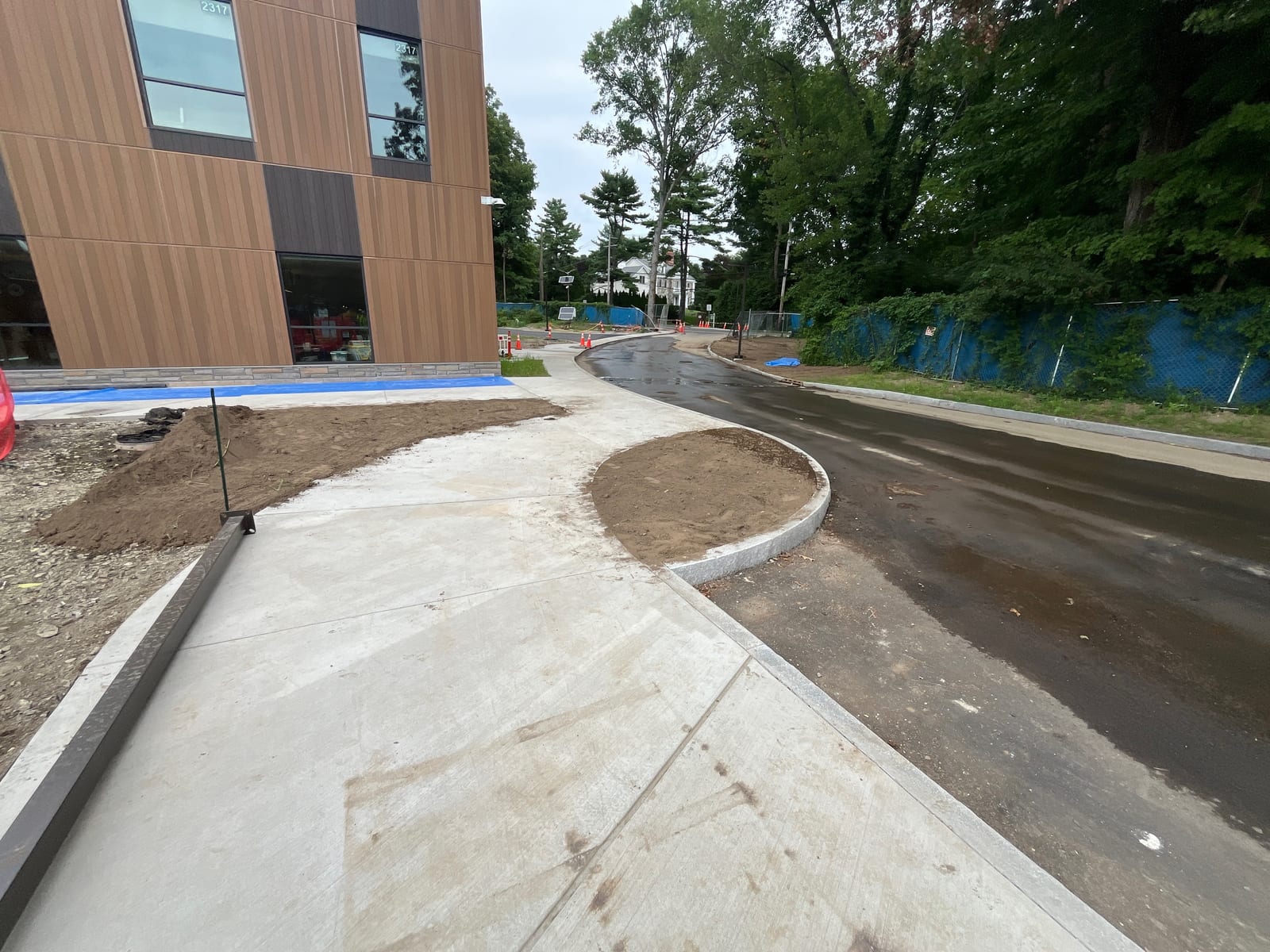

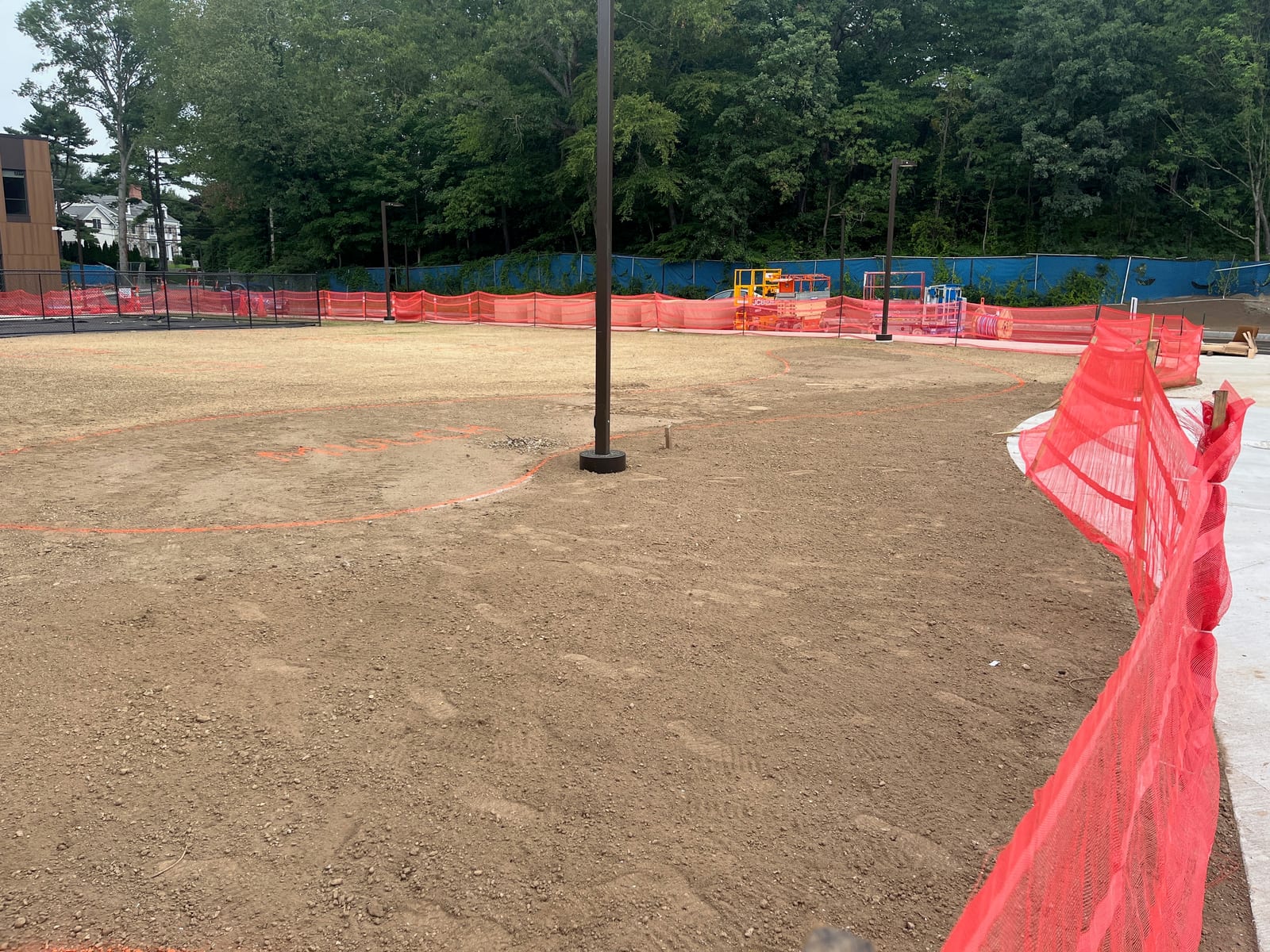

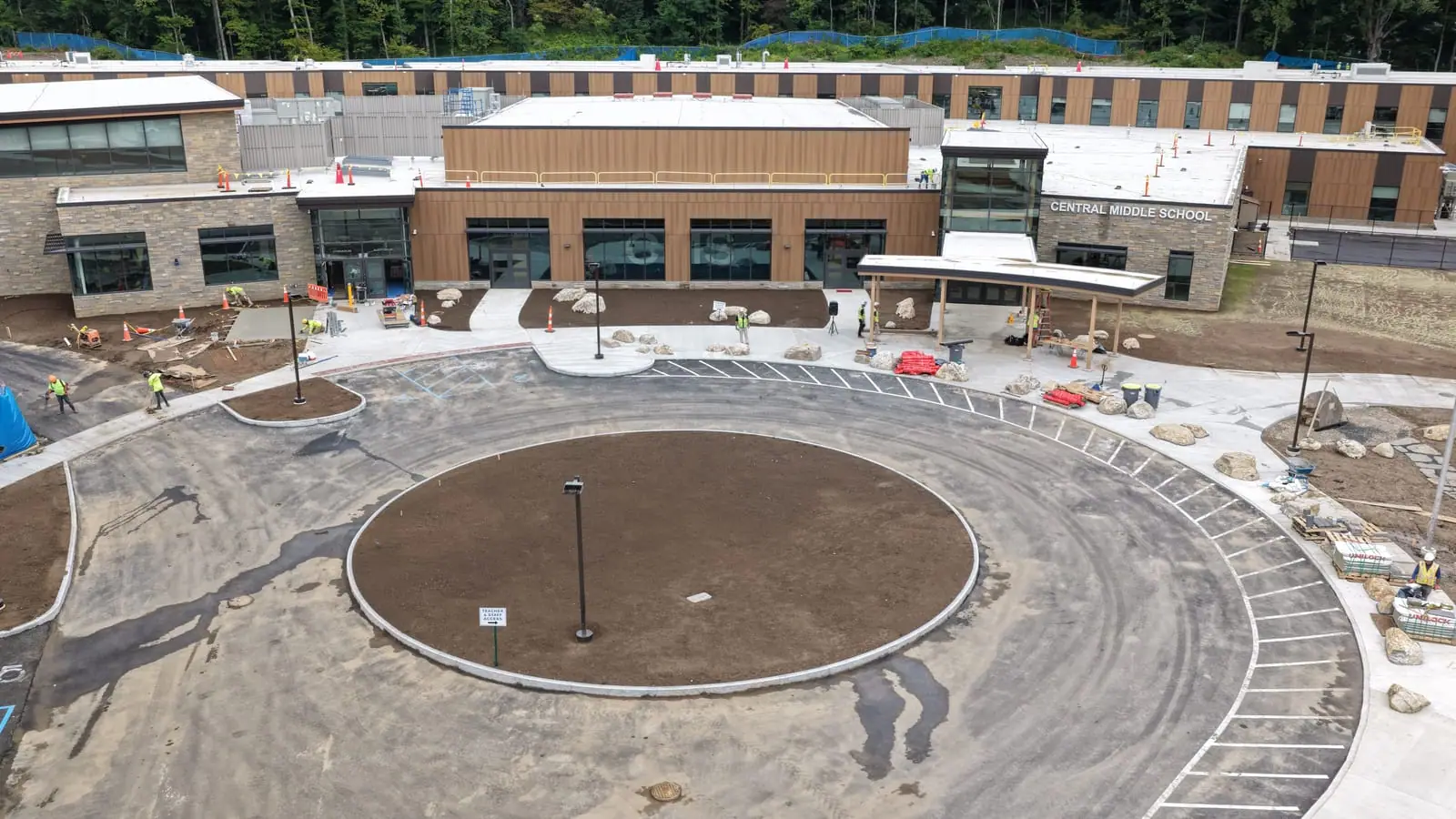

Friday Morning: Prepared Soil, No Sod Yet

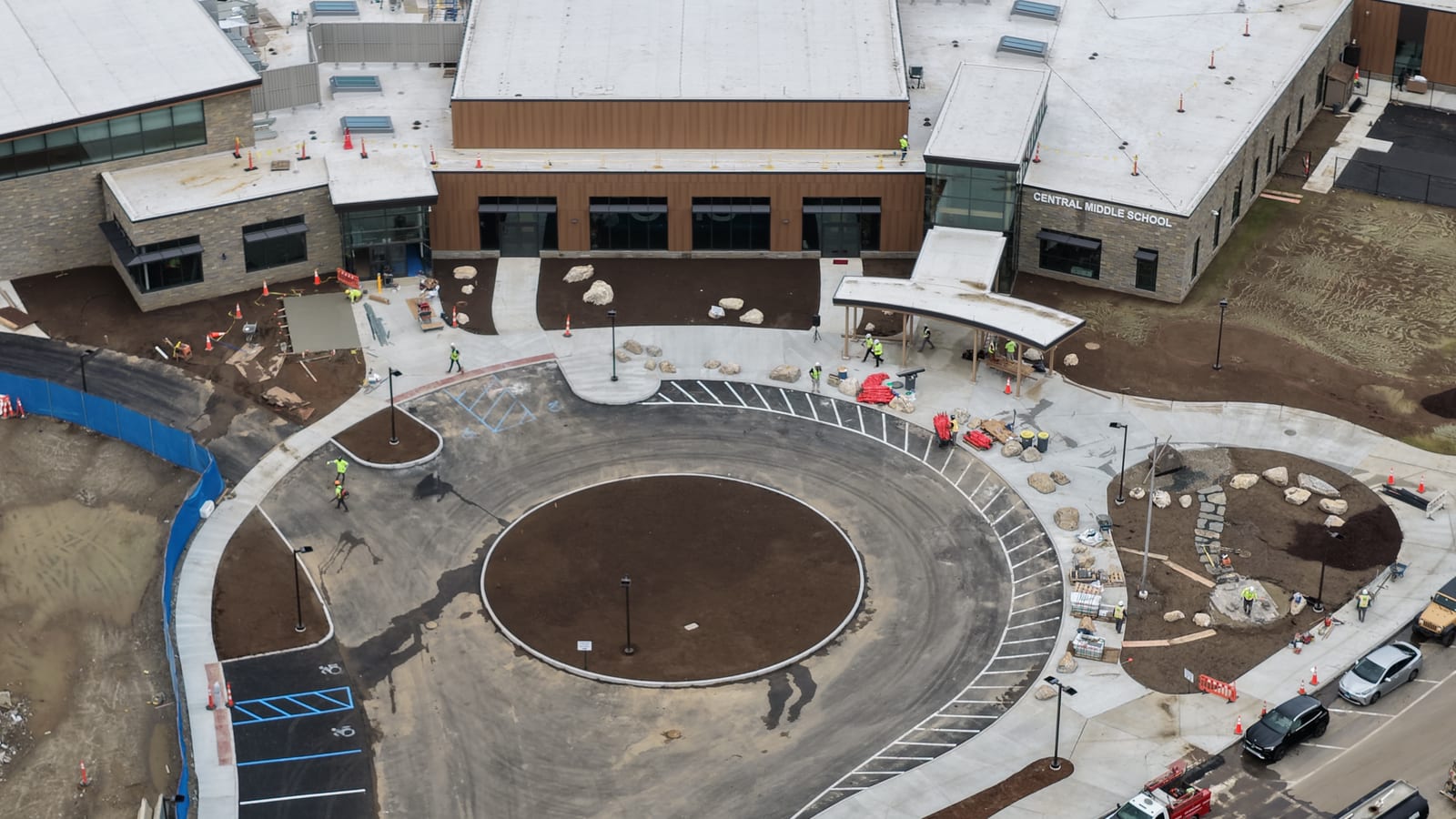

The hero aerial at the top of this page was taken Friday morning. The next views continue that before-installation record, showing the entrance circle, curved walks, school frontage, and open lawn zones before CT Sod began laying 11,000 square feet.

At this point, the deadline had not changed. The site still needed to move from open soil to a finished entrance lawn before the public event on Monday.
Friday Afternoon: The 11,000-Square-Foot Transformation

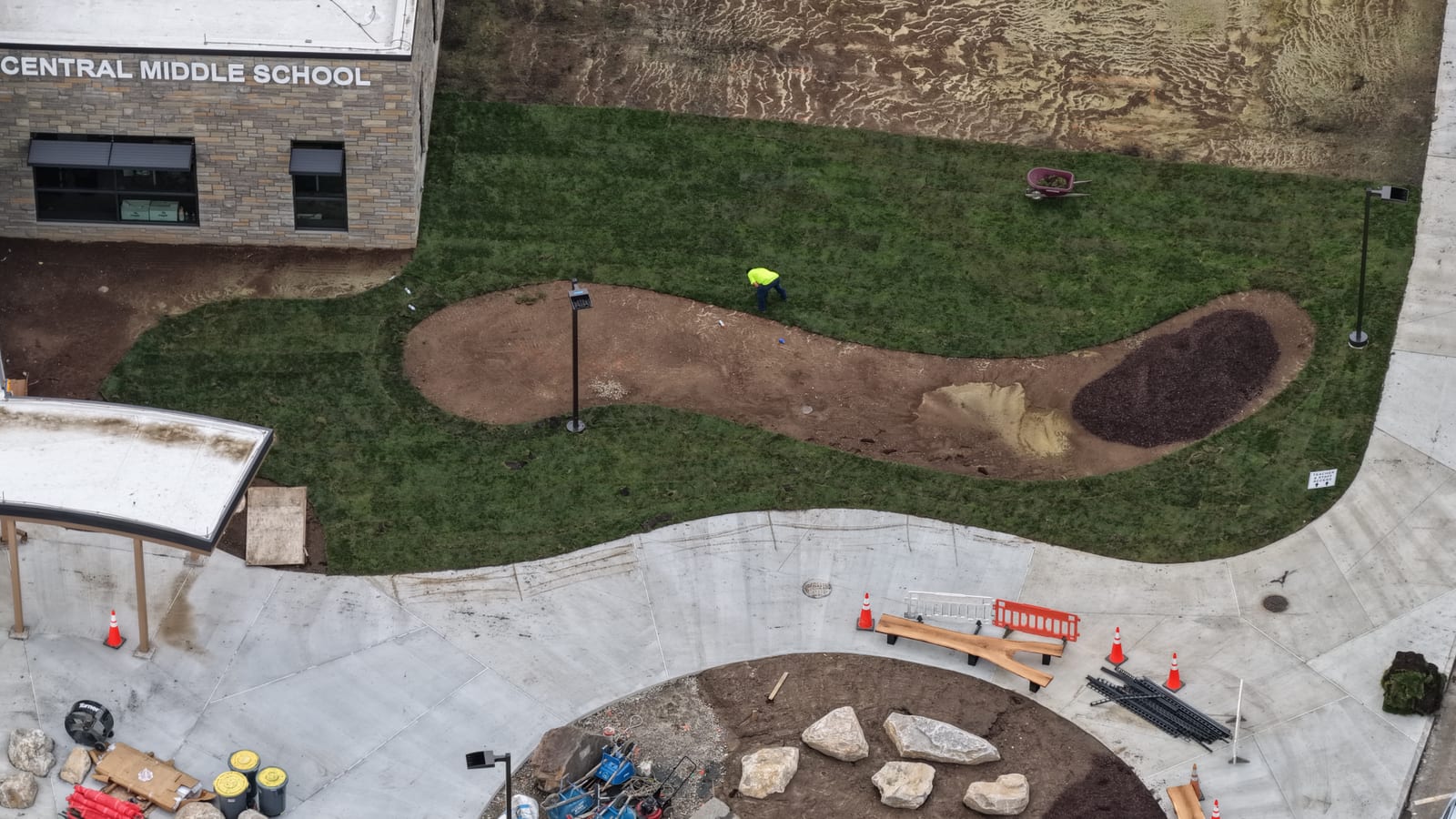

Fresh sod arrived against the install date and was staged around the active school site — flatbeds of farm-cut pallets unloaded beside the new building while the crew worked. The progress views below show the entrance circle turning green first, then the lawn extending along the building frontage, walks, and designated campus zones.

The visible result is a green campus. The operational result is an 11,000-square-foot sod scope completed inside a three-day response window.

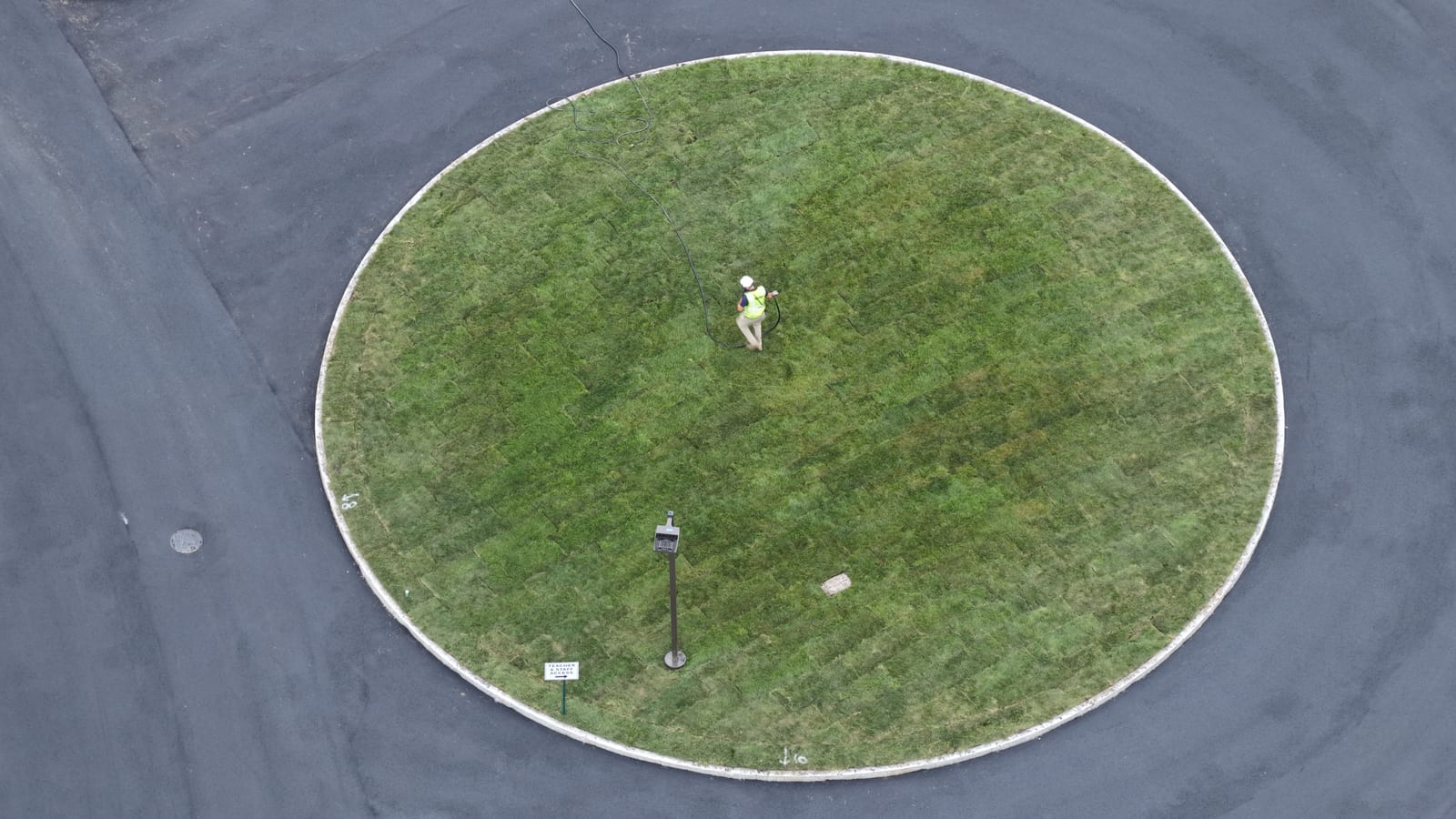

Friday Completion: The Finished School Lawn

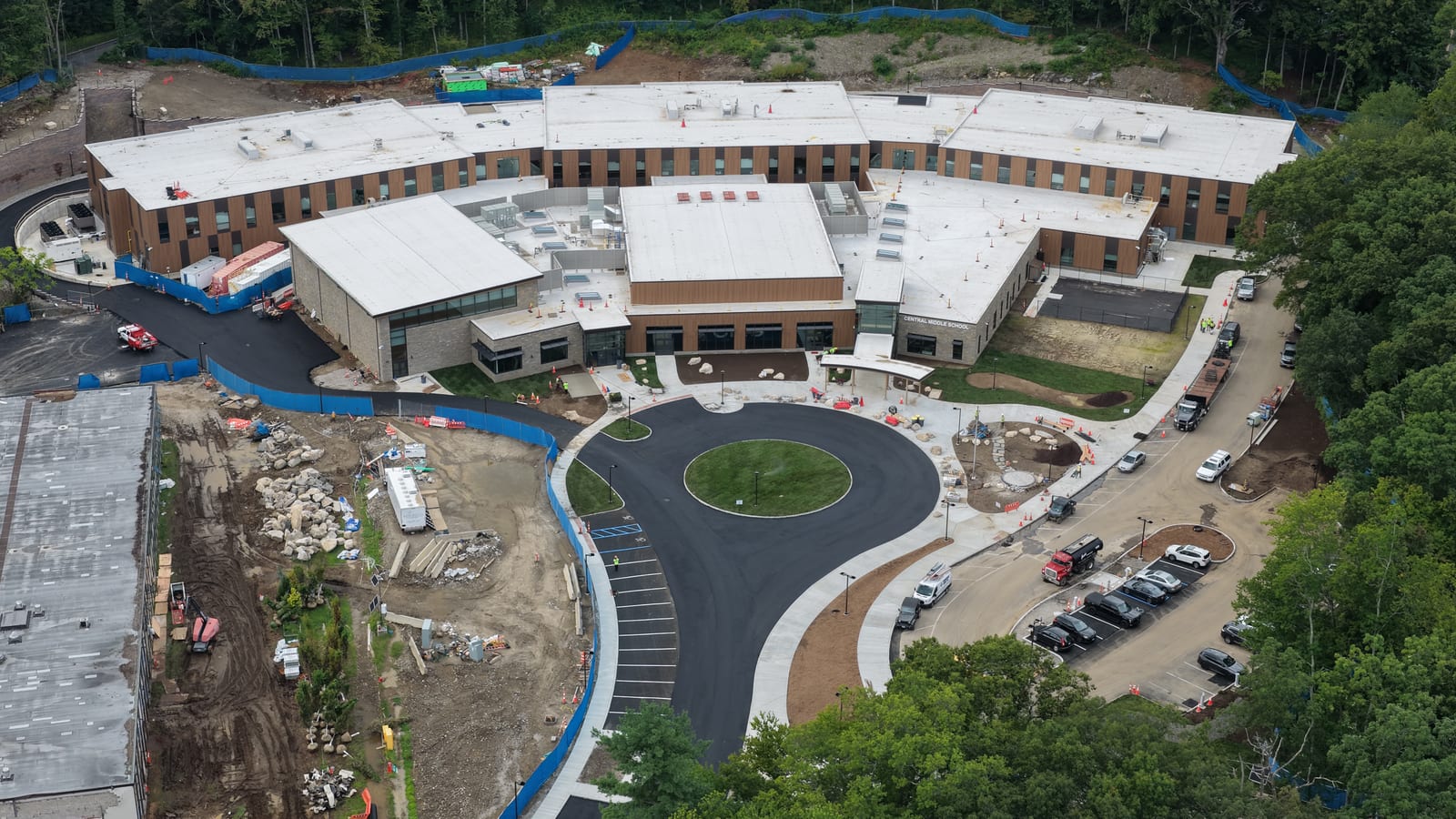

By late afternoon on Friday, August 21, 2026, CT Sod's assigned turf areas were complete. The final aerials show finished sod at the school entrance, around the main circle, beside the building, along the curved walks, and across the deadline-critical lawn zones.

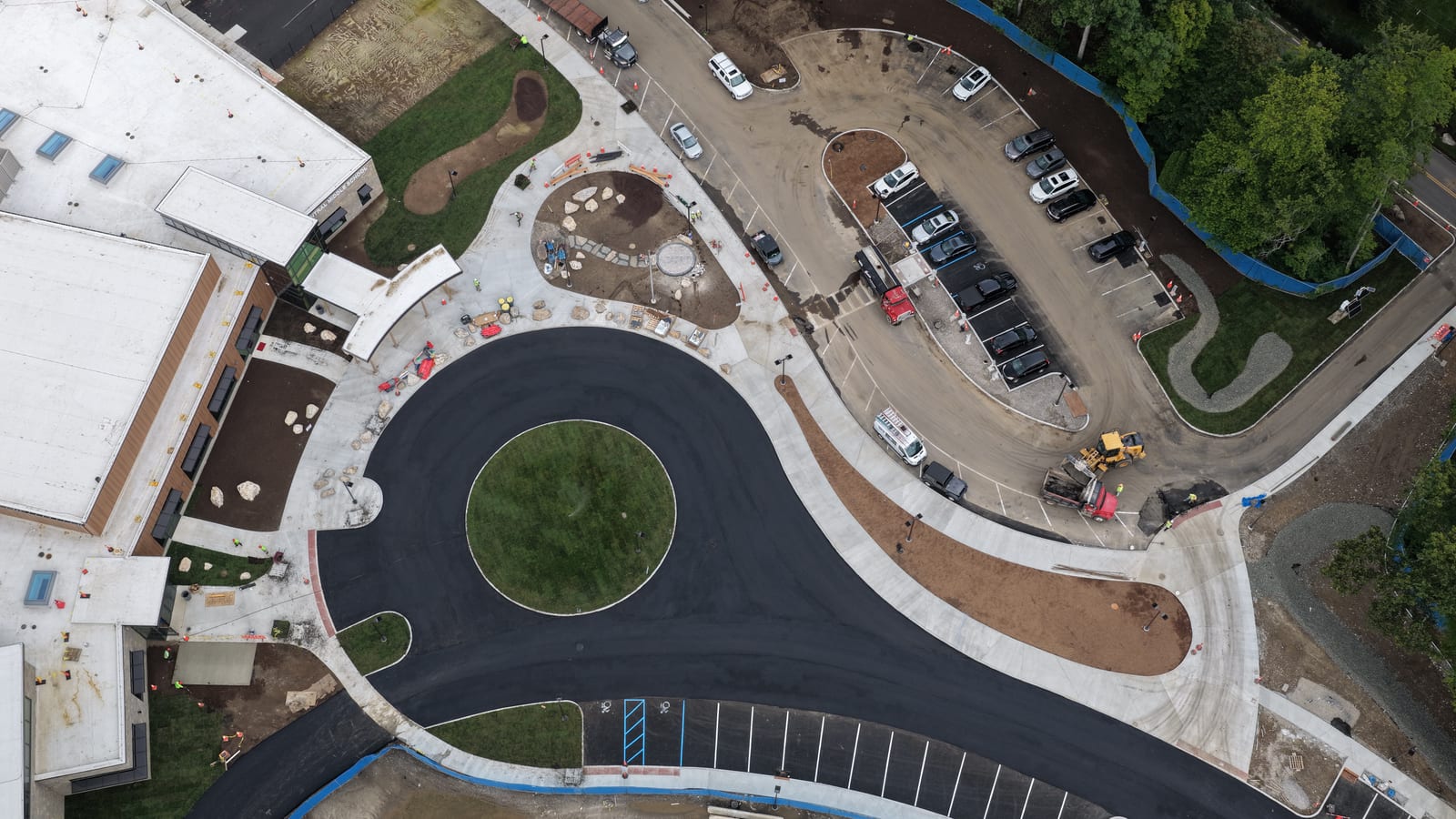

The Sod Scope and the Separate Hydroseed Scope
CT Sod supplied and installed the 11,000 square feet of finished sod shown here. The remaining open-soil areas visible elsewhere on the construction campus belong to the project landscaper's separate hydroseed plan. CT Sod did not perform that hydroseeding.
The campus-wide view matters because it shows both scopes in the same frame without confusing them. Sod was used where the project needed an immediate finished lawn for the opening. Hydroseed was reserved by the project's landscaper for other areas outside CT Sod's assignment.

Complete Greenwich School Video Archive
The case study above uses the strongest clips in chronological order. Browse all 17 project videos below for additional before, installation-progress, and finished-campus views.
- Friday pre-install drone walkthrough
- Pre-install construction-zone flyover
- Pre-install entrance-circle overhead
Installation in Progress
- Main-circle installation progress aerial
- Entrance installation progress flyover
- Curved-walkway installation progress aerial
- Friday-afternoon sod progress aerial
Finished School and Campus
- Finished entrance aerial
- Finished entrance-building aerial
- Finished main-entrance detail
- Finished building-side lawn pass
- Finished building-side flyover
- Finished entrance wide aerial
- Finished school flyover
- Finished campus overview
- Finished campus-context flyover
- Finished campus pullback
What This Deadline Project Demonstrates
The Greenwich sod guide's school timeline connects this deadline project to townwide soil, access, sequencing, and rules.
Sod gave the school an immediate finished lawn on Friday. Hydroseed can be right where other parts of a site have time to establish, but it does not create the same day-one surface for a Monday ribbon cutting.
For Central Middle School, the advantage was practical:
- Immediate appearance: the assigned lawn areas looked complete as soon as installation and watering were done.
- Defined scope: the deadline-critical entrance lawns could be assigned to sod while other areas remained in a separate landscaper plan.
- Fresh material: the sod was harvested against the installation date rather than held as yard inventory.
- Schedule certainty: the visible result did not depend on germination after the event date.
Ready For A Finished Lawn?
Need it installed?
Sod-only crews, up to 30,000 sq ft a day across the Northeast.
Frequently Asked Questions
Is the Central Middle School sod installation complete?+
Did CT Sod hydroseed the remaining areas at Central Middle School?+
Which sod company did Turner Construction bring in?+
Can CT Sod handle rush commercial sod installations?+
Does CT Sod install sod for schools and active construction sites?+
Keep Reading

Greenwich, CT Sod Guide: Rules, Access & an 11,000 Sq Ft Job

The Shelton, CT Sod Guide: The Lawn After a Pool Build, Shelton's First Year on Aquarion's Watering Schedule, and What 17,000 Sq Ft From the Air Taught Us

The New Canaan, CT Sod Guide: Estate-Scale Installs, Ridge Soil, Wells and Septic, Wetlands Rules, and What Three Real Jobs Taught Us
