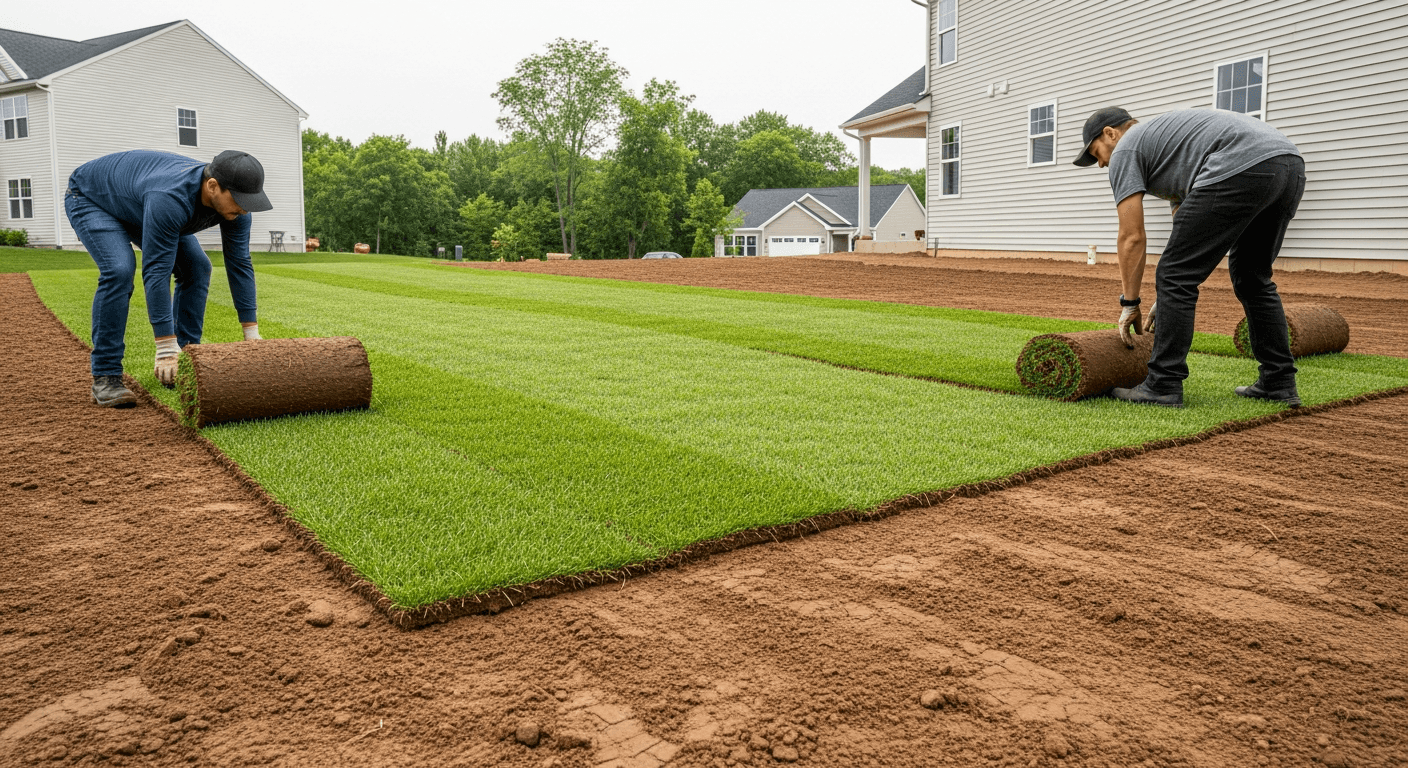

On a new build, sod goes in last — after final grade, utilities, and irrigation, once the lot is no longer an active work zone — and it succeeds or fails on two things the builder controls: the soil it's laid on, and the timing relative to the season and the certificate of occupancy. Get those two right and the lawn is finished, rooted, and presentable for the final walk-through; get them wrong and you inherit a callback after closing. This guide covers how to sequence, spec, prep, and budget sod on a new construction project in the Northeast — written for builders, general contractors, and landscape architects, not homeowners.
CT Sod delivers and installs farm-cut Kentucky Bluegrass, Tall Fescue, and RTF across Connecticut, Massachusetts, New York, New Jersey, Rhode Island, New Hampshire, Vermont, and Maine — with white-label crews that lay up to 30,000 square feet in a day so even large projects close on schedule.
When does sod go in during new construction?
Sod is the last major site item — installed after the lot is graded, the underground work is done, hardscape is set, and irrigation is in and tested. Putting it in earlier means turf gets destroyed by ongoing traffic, or sits compacted and rutted before the homeowner ever sees it. The clean sequence:
| Construction phase | Sod-related reality |
|---|---|
| Excavation & foundation | Existing topsoil is stripped and stockpiled — or, too often, hauled off and sold. Track where it went. |
| Framing → rough-ins | Active work zone. No turf. |
| Utilities & underground | Sewer, water, electric, gas trenched; irrigation sleeves and mainline roughed in under future hardscape. |
| Hardscape & driveway | Patios, walks, and driveway set before final grade so elevations are fixed. |
| Final grade & topsoil | 3–6 inches of quality topsoil spread over a decompacted subgrade, graded to fall away from the foundation. |
| Irrigation install & test | Heads set and the system pressure-tested before sod covers any lines. |
| Sod | Laid last, within 24 hours of delivery, once heavy traffic is finished and the site is clean. |
| Aftercare | The 14-day watering protocol starts the day it's laid — assigned to a responsible party (see warranty section). |
The single scheduling rule that matters: sod should be installed within 24 hours of delivery. It's a perishable, living product, not pallets of pavers that can sit. On a build, that means the site has to be fully prepped and ready *before* the truck is scheduled — not "we'll finish grading while they unload."
The number-one new-construction sod mistake
The most common reason new-construction lawns fail is that the sod is laid over compacted, stripped subsoil instead of real topsoil. Excavation and months of heavy-equipment traffic compact the ground until water can't infiltrate and roots can't penetrate. Meanwhile the native topsoil that took decades to build is frequently scraped off and sold during sitework. What's left at final grade is dense, lifeless subgrade — and sod laid directly on it roots poorly, yellows, and peels.
The fix is not optional and it's not expensive relative to the callback it prevents:
- Decompact the subgrade before topsoil goes down — rip or till the surface so the new soil bonds to it instead of perching on a hardpan.
- Spread 3–6 inches of quality topsoil, graded smooth and pitched to drain away from the house. Two inches is not enough on a new build; see how deep topsoil should be for sod and the best topsoil for sod.
- Confirm grade and drainage before ordering. A site walk before order placement catches access, prep status, and logistics problems while they're still cheap to fix — our full before you order checklist covers what we look for.
What goes under the sod
Two things decide how fast a new lawn roots down — and fast root-down is what keeps a new-construction lawn alive through the buyer's first season: a soil test of the topsoil before it's spread, and the right starter at the soil-to-sod interface. New sod does not need the heavy high-phosphorus starter that seed does — most established topsoil already carries enough phosphorus, and an excess can actually slow rooting. Test the topsoil you're bringing in (it's the cheapest insurance on the whole job — see do you need a soil test before laying sod), then match what goes down to what the soil actually lacks. For the full comparison of what to put under new sod — high-P starters, 10-10-10, compost, and purpose-built options — see the best fertilizer to put under new sod. The faster the sod knits to the soil, the fewer callbacks land on your desk after closing.
How to spec sod in a build contract or allowance
Spell sod out as its own line — variety, square footage, install method, prep scope, and who owns aftercare — so it's not a vague "lawn allowance" that turns into a dispute at closing. A clean sod spec includes:
- Variety and blend (e.g., "Kentucky Bluegrass blend" or "RTF tall fescue") — not just "sod."
- Total square footage, measured at final grade with 5% added for cuts and waste around curves, beds, and edges.
- Prep responsibility — who decompacts, supplies, and grades topsoil, and to what depth. This is the most-fought item; name it.
- Install method — delivered for the landscaper to lay, or full prep-and-install by the sod crew.
- Aftercare assignment — who waters during the critical first 14 days, especially when closing date and install date don't line up.
What's the best sod variety for a new construction home in the Northeast?
For most new builds, a Kentucky Bluegrass blend gives the finished "model-home" look at closing, while RTF or Black Beauty tall fescue is the better spec where durability, shade, or low input matter more than instant curb appeal. All are cool-season grasses suited to the Northeast.
| Variety | Best for on a new build | Look at closing | Durability |
|---|---|---|---|
| Kentucky Bluegrass / KB blend | Model-home curb appeal, sunny lots | Classic dark blue-green — the most "finished" look | Self-repairs via rhizomes; wants full sun and water |
| Black Beauty Tall Fescue | Mixed sun/shade lots, heat and drought tolerance | Deep green, slightly coarser blade | Deep-rooted, tough, drought-tolerant |
| RTF (Rhizomatous Tall Fescue) | High-traffic lots; spec where long-term durability is the priority | Deep green, self-filling | Best long-term — spreads to fill thin spots |
| Bluegrass–Fescue Blend | The all-around default for most Northeast lots | Lush blue-green | Balances bluegrass color with fescue toughness |
Heavily shaded lots are the exception — those want a fine-fescue approach rather than bluegrass. Match the variety to the lot's sun, soil, and intended use; a south-facing open lot and a tree-shaded one are different specs.
How much sod do you need, and how does delivery work at builder volume?
Divide the total prepped square footage by 500 to estimate standard pallets, then add ~5% for cuts and waste. Each pallet covers 500 square feet (up to 600 on request). For the full breakdown by grass type and cut format, see how many square feet are in a pallet of sod.
At builder and estate scale, logistics is what determines the outcome:
- All-terrain forklift placement puts pallets exactly where the crew needs them on a raw or tight site — covered on our sod pallet delivery page.
- Staggered / just-in-time delivery on large lots keeps sod from sitting and drying while earlier sections are laid.
- Volume and phased pricing for programs — production builders running multiple homes or a subdivision can lock volume pricing and phase delivery across staggered closings rather than ordering lot by lot.
- Dedicated trucking and scaled crews for substantial projects (our before you order framework puts full new-construction landscaping in the 10–40 pallet / 5,000–20,000 sq ft range, with capacity well beyond that).
- A site walk before the order confirms access, prep status, and permit needs (street access, right-of-way) so delivery day isn't the day problems surface.
Who installs it — and the white-label option for GCs and landscapers
You have three paths, and the right one depends on whether you have your own crew:
- Delivery only — we drop fresh-cut sod, forklift-placed, and your landscaper lays it. Many of our contractor customers work this way.
- Full prep + install — we decompact, supply and grade topsoil, and lay the lawn. Installation minimum is 1,200 sq ft; prep is quoted with the install.
- White-label crews for the trade — we sub-contract for landscapers and general contractors across the Northeast, laying up to 30,000 square feet in a day, with your client relationship staying entirely yours. When you've sold the job and need installed turf done fast and right under your own name, this is the path. Call (203) 806-4086 for contractor pricing.
Scheduling sod around the certificate of occupancy and closing
Aim to install sod close enough to closing that the lawn is green and rooting for the final walk, but inside a real establishment window. Cool-season sod installs successfully from roughly late April through late October in the Northeast, with the strongest establishment windows in spring (April through early June) and fall (mid-August through September).
When the closing date and the ideal window don't align:
- Summer closings (July–August): sod can go in, but it must be watered immediately and heavily — heat plus a new buyer who hasn't moved in yet is the classic failure setup. Assign watering explicitly.
- Late-fall / winter closings: dormant sod can be laid later than most people think, but it won't green up until spring. Set buyer expectations in writing rather than getting a "the lawn is brown" call in December.
The mistake is treating sod like a finish that can slot in at any point. Back the install date out from both the season and the closing, and lock the prep to be ready before the truck.
Warranty, liability, and the callback problem
On new construction, most sod "failures" are aftercare failures, not product failures — so the single highest-leverage move is naming, in writing, who waters the lawn for the first 14 days. Fresh-cut sod laid on properly prepped soil roots reliably; sod that goes a hot weekend without water after a Friday install does not, regardless of quality.
To keep new-construction sod off your callback list:
- Document the prep (topsoil depth, grade, drainage) — it's the variable that actually causes root failure.
- Assign aftercare in the contract — builder, landscaper, or buyer — and hand over the first-14-days watering guide at closing.
- Use fresh-cut, installed-within-24-hours sod rather than retail pallets that have sat — the difference shows up three weeks later, after you've moved on to the next job.
Budgeting sod into the build
Single pallets start at $699, and delivered sod runs from about $0.90 per square foot at small volume down into the $0.60s per square foot as the job grows — with builder and contractor pricing quoted below retail, separate from prep, grading, and irrigation. Keep these as distinct line items in the budget:
- Sod (delivered, by the square foot at volume)
- Install (if using our crews; 1,200 sq ft minimum)
- Prep (decompaction, topsoil supply and grading — quoted with the job)
- Irrigation (separate trade, scheduled before sod)
*CT Sod delivers and installs fresh-cut sod across CT, MA, NY, NJ, RI, NH, VT, and ME. For builder, estate, and commercial pricing, call (203) 806-4086.*
